The new Titans stadium Nashville project represents one of the most significant urban development investments in modern city history. Approved in 2022, construction began in February 2024, and the approximately $2.1 billion enclosed venue is scheduled to open in spring 2027. Located on the East Bank of the Cumberland River, the stadium anchors roughly 550 acres of planned redevelopment that will reshape housing demand, infrastructure investment, and long-term neighborhood identity in Davidson County.
As vertical construction becomes increasingly visible through 2024 and 2025, the East Bank is shifting from long-term vision to tangible expansion. For buyers, sellers, and investors in Nashville real estate, this transition marks a structural change in how the urban core is growing across the river.

Key Takeaways
- The new Titans stadium Nashville project was approved in 2022.
- Construction began in February 2024.
- The enclosed venue is scheduled to open in spring 2027.
- The stadium anchors a 550-acre East Bank redevelopment area.
- River North and Oracle-related employment growth reinforce long-term demand.
New Titans Stadium Nashville Announcement and Approval
In 2022, the Tennessee Titans, Metro Nashville, and the State of Tennessee finalized an agreement to construct a new enclosed stadium on the East Bank. The agreement included state participation, bond-supported funding mechanisms, and a long-term lease securing the franchise in Nashville for decades.
City leadership framed the project as more than a stadium replacement for Nissan Stadium. It was positioned as a catalyst for East Bank redevelopment and long-term riverfront transformation.
Approval marked the transition from concept to execution.
New Titans Stadium Nashville Construction Timeline
Large urban stadium developments unfold in coordinated phases. The Nashville project reflects deliberate sequencing between vertical construction and surrounding infrastructure improvements.
2022 Agreement Phase
- Final stadium approval
- Funding structure formalized
- Lease commitments secured
- Architectural refinements led by Manica Architecture
2023 Preconstruction Phase
- Engineering and structural plans finalized
- Tennessee Builders Alliance confirmed as construction lead
- Utility relocation planning across the East Bank
- Traffic staging plans coordinated with ongoing Nissan Stadium operations
Preconstruction often determines how efficiently adjacent residential and mixed-use projects can scale.
February 29, 2024 Groundbreaking
Construction officially began with:
- Earthwork and grading
- Site stabilization
- Foundation excavation
- Pile driving
- Structural base preparation
This phase established the footprint for vertical construction.
2024 to 2025 Structural Buildout
Visible progress accelerated through:
- Structural steel installation
- Seating bowl framework
- Core and shell construction
- Mechanical, electrical, and plumbing systems
- Stormwater and utility integration
At the same time, roadway modifications and pedestrian planning advanced to support long-term East Bank connectivity.
2026 Enclosure and Interior Completion
Focus shifts toward:
- Roof structure installation
- Exterior facade systems
- Interior seating and concourse buildout
- Technology integration
- Safety compliance and event systems testing
This phase transitions the project from structural development to operational readiness.
Spring 2027 Opening
The new enclosed stadium is scheduled to open in spring 2027. It will host:
- Tennessee Titans home games
- Tennessee State football
- Concerts and national events
- Community and civic gatherings
Opening activates the broader East Bank district.

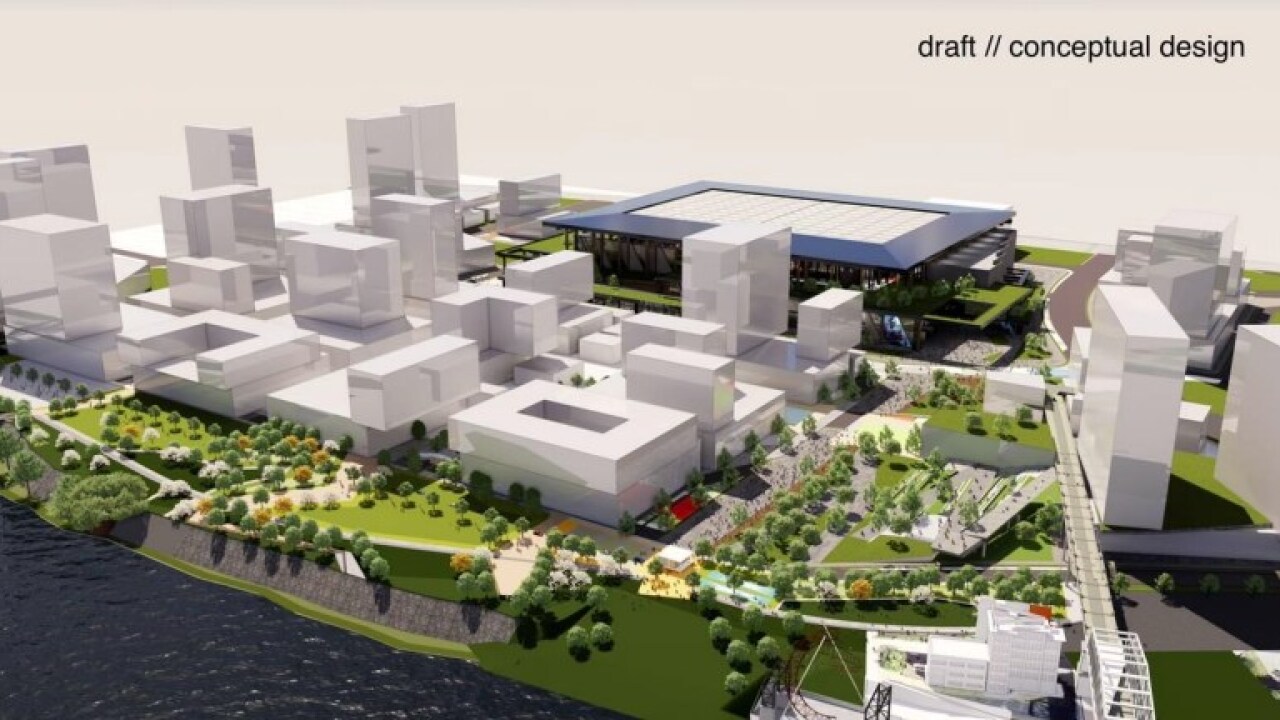

East Bank Development Nashville and Long-Term Housing Demand
The stadium sits within a broader East Bank redevelopment area spanning approximately 550 acres. The long-term plan includes:
- Mixed-use residential development
- Hospitality and hotel projects
- Retail corridors
- Public green space
- Enhanced pedestrian and riverfront access
Metro Nashville’s East Bank framework positions this area as a true extension of downtown rather than a peripheral 550 acre district.
Infrastructure investment and zoning evolution are already reshaping the development pipeline.
River North and Oracle Employment Growth
One mile north, the River North corridor continues advancing alongside the planned Oracle campus. Employment-driven development reinforces the East Bank’s long-term viability.
When job growth and placemaking occur simultaneously, residential demand often strengthens.
The proximity between River North and the new Titans stadium Nashville project compounds that effect.
Real Estate Impact in Davidson County
The new Titans stadium Nashville development influences several measurable dynamics across Davidson County and certainly impacts the housing market outlook.
Residential Demand
As construction visibility increases, buyer psychology shifts. Apartments and condos near activation zones often see increased attention as uncertainty declines. Investors evaluating long-term positioning are increasingly studying how the Nashville investment property strategy evolves alongside East Bank infrastructure and employment growth.
Hospitality and Retail Growth
An enclosed venue hosting year-round events creates consistent foot traffic. That consistency supports hotel feasibility and restaurant density.
Infrastructure as a Long-Term Value Support
Road improvements, pedestrian bridges, and utility upgrades expand usable geography. Infrastructure investment typically supports property values over multi-year horizons.
Identity and Perception Shift
The East Bank will transition from event overflow space into an integrated urban neighborhood. Perception shifts often precede measurable pricing changes.
Frequently Asked Questions
When will the new Titans stadium open?
The new enclosed stadium is scheduled to open in spring 2027.
How much does the new Titans stadium cost?
The project cost is approximately $2.1 billion.
Where is the new Titans stadium located?
The stadium is being constructed on the East Bank of the Cumberland River in downtown Nashville.
Will the new stadium increase property values?
Real estate impacts typically unfold gradually. Infrastructure investment and district activation often support long-term demand, though pricing changes vary by timing and property type.

What Nashville Property Owners Should Monitor
Through 2027, pay attention to:
- Rezoning and land assemblage activity
- Multifamily and condo project announcements
- Hospitality development timelines
- Infrastructure completion milestones
- Absorption trends in adjacent neighborhoods
Real estate impacts occur in phases. Early positioning often precedes activation. Property owners should also monitor how Nashville mortgage rates conditions evolve, as interest rate movement will influence absorption, pricing leverage, and transaction timing around the East Bank corridor.
Nashville East Bank Real Estate Outlook Through 2027
The new Titans stadium Nashville project represents structural change to Nashville’s riverfront geography. Construction visibility, infrastructure upgrades, and River North employment growth combine to reshape demand patterns across the East Bank.
By 2027, the East Bank will function as an integrated urban district connected to downtown and River North.
For buyers, sellers, and investors, understanding this timeline is essential. Structural change rewards informed positioning.
